Another day, another update on the 2025 construction season here in Moose Jaw.

Public Works

public works closures


Closure Permits

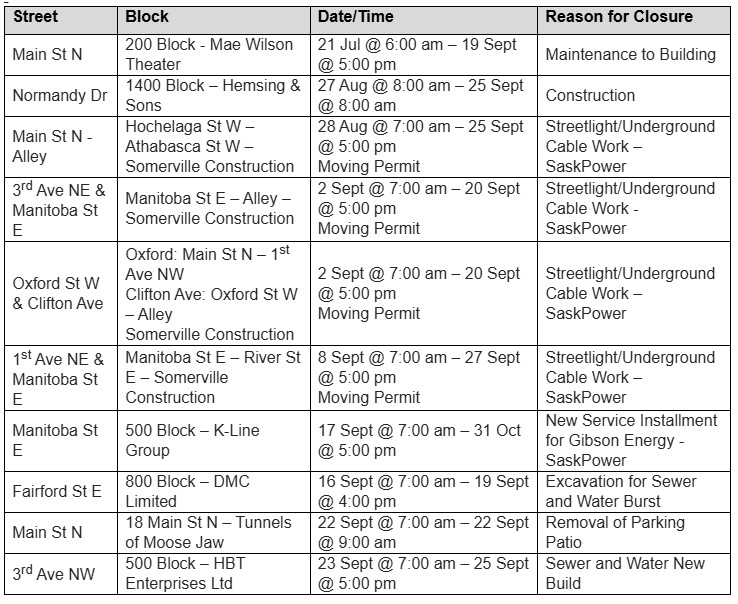

closure permits


Event Permits

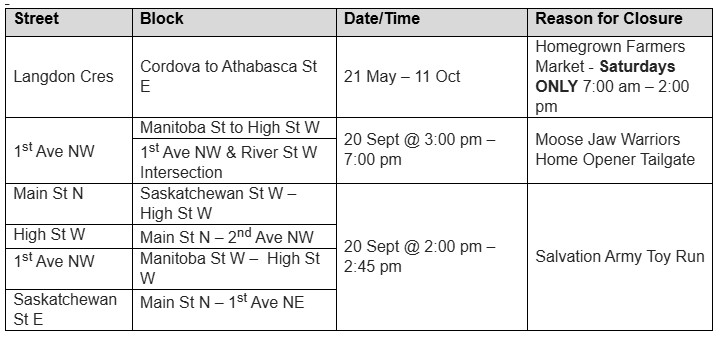

event permits


Capital Projects

2nd Ave NE & Manitoba St. E intersection

Work is ongoing at the intersection of 2nd Ave NE and Manitoba Street E to upgrade controls and traffic flow. The Trucks and Dangerous Materials Route has been redirected around the city.

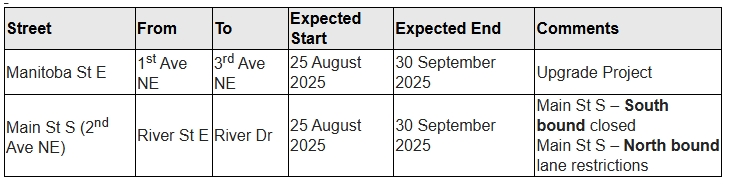

Second ave closure


Sewer Dig Repair

Several locations are undergoing sewer dig work within the city:

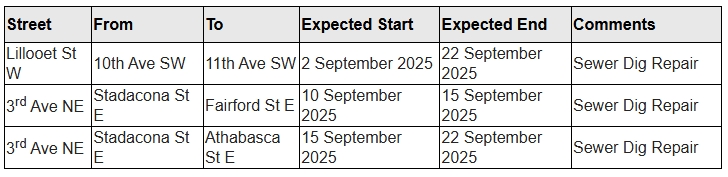

sewer digs


Coteau St. W Road Improvement

Coteau St. W


Sewer Lining Program (Pre-Cleaning)

Sewer Lining Program


Infrastructure Renewal Program

4th Ave SW – Duffield St to Coteau St (Started May 5th, 2025)

Duffield St intersection is open.

Coteau St W intersection is closed.



Coteau St W – 4th Ave SW to 5th Ave SW (Started June 9th, 2025)

4th Ave SW intersection will be closed.

5th Ave SW intersection will be closed.



Coteau St W – 5th Ave SW to 6th Ave SW (Starting July 24th, 2025. Estimated End September 24th, 2025.)

5th Ave SW intersection will be closed starting July 24th, 2025.

6th Ave SW intersection is open.
